HomeImprovementPreloading with Surcharge Design

Preloading with Surcharge Design in Bradford

On a recent project near the Leeds-Liverpool Canal in Bradford, our team mobilized a fleet of tracked excavators and vibrating rollers to place a 4-meter-high surcharge fill over a 2,000 m² site. The soil profile there, typical of the Aire Valley's alluvial deposits, consisted of soft silty clays and peat layers extending up to 8 meters deep. We installed pneumatic piezometers and settlement plates to monitor pore pressure dissipation and surface heave. The preloading with surcharge design required careful staging to avoid bearing failure—especially given the high water table common in Bradford's low-lying areas. Before loading, we conducted a series of in-situ tests including ensayo SPT to correlate N-values with undrained shear strength and ensayo CPT for continuous stratigraphic profiling. These data fed directly into the consolidation settlement estimates used to size the surcharge height and duration.

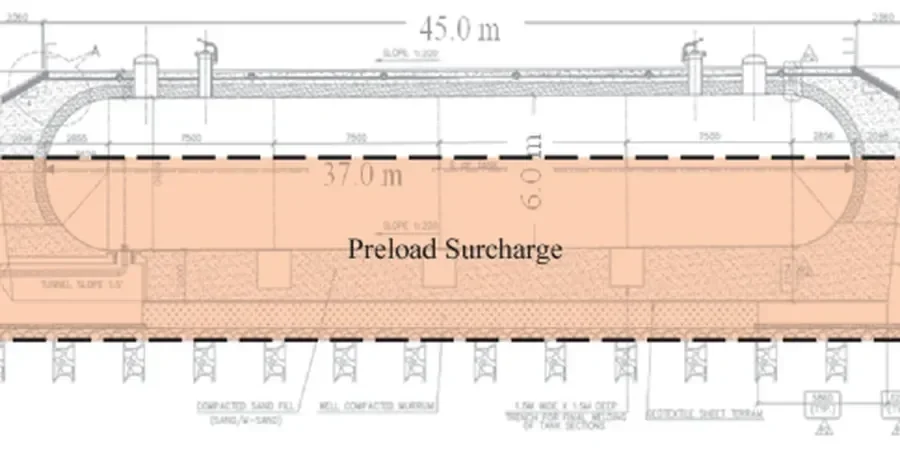

Illustrative image of Preloading with surcharge design in Bradford
In Bradford's soft alluvium, a surcharge ratio of 1.3 can cut primary consolidation time by 40% compared to conventional preloading alone.

Method and coverage

Eurocode 7 (BS EN 1997-1:2004) provides the design framework for preloading with surcharge in Bradford, particularly regarding serviceability limit states for settlement. The city's variable glacial till and lacustrine deposits demand a cautious approach. Key parameters include the coefficient of consolidation (cv), compression index (Cc), and preconsolidation pressure (pc). We routinely run CRS and incremental loading oedometer tests on undisturbed samples retrieved from thin-walled Shelby tubes. To capture the full stress range, we also perform consolidacion tests at multiple load increments. For projects on Bradford's deeper soft clay strata, we integrate the Asaoka method to predict field settlement rates from monitored data. The surcharge ratio—typically 1.2 to 1.5 times the design load—is optimized to achieve 90% primary consolidation within 3 to 6 months, depending on drainage path length and vertical drain spacing.

Regional considerations

A warehouse development in Bradford's Shipley district experienced differential settlement of 120 mm over a 40-meter length due to an underestimated peat lens. The preloading with surcharge design had not accounted for the lens's higher compressibility. We remediated by removing the affected area, installing a 1.5-meter deep granular blanket, and re-applying a staged surcharge with additional settlement plates. The lesson is clear: even with thorough borehole data, Bradford's erratic glacial deposits can hide isolated soft pockets. That is why we always couple preloading with settlement monitoring and, when needed, drenes-verticales to accelerate drainage. A flexible approach—allowing surcharge removal dates to shift based on real data—saves both time and repair costs in Bradford's challenging ground conditions.

Need a geotechnical assessment?

Reply within 24h.

Email: contact@geotechnical-engineering.biz

Standards that apply


Eurocode 7 (BS EN 1997-1:2004), BS 5930:2015 (Code of practice for ground investigations), BS EN 1997-2:2007 (Ground investigation and testing), CIRIA C760 (Guidance on preloading and vertical drains)

Complementary services

01

Surcharge Fill Design & Staging

We calculate optimal surcharge height and staging sequence based on oedometer test results and settlement analyses. Our designs include stability checks for the embankment itself, ensuring factor of safety above 1.4 during construction.

02

Field Monitoring & Performance Verification

We install settlement plates, pneumatic piezometers, and inclinometers to track consolidation progress. Real-time data feeds allow us to adjust surcharge duration and confirm when 90% consolidation is reached before removal.

Typical parameters


ParameterTypical value
Surcharge height3.0 - 5.5 m
Preconsolidation pressure (pc)80 - 180 kPa
Coefficient of consolidation (cv)1.5 - 4.2 m²/year
Compression index (Cc)0.25 - 0.55
Target degree of consolidation≥ 90%
Monitoring duration3 - 8 months
Vertical drain spacing (if used)1.2 - 2.0 m triangular

Top questions

How does preloading with surcharge work on Bradford's soft ground?

A temporary fill higher than the final design load is placed to accelerate consolidation of soft clay and peat layers. The surcharge squeezes out pore water, increasing effective stress and reducing future settlement. In Bradford, where alluvial clays often have low permeability, we combine it with vertical drains to cut consolidation time from years to months.

What is the typical cost range for a preloading with surcharge design in Bradford?

For a medium-sized site (0.5–1 hectare), the design and monitoring package typically falls between £650 and £2,170. This covers site investigation review, settlement analysis, monitoring plan, and field supervision. Excavation and fill placement costs are additional and depend on material availability and haul distance.

How long does preloading take before construction can begin in Bradford?

Duration depends on soil compressibility, drainage path length, and target consolidation degree. With vertical drains, 90% consolidation in Bradford's soft clays is usually reached in 3 to 6 months. Without drains, it can extend to 12–18 months. We monitor pore pressure dissipation to confirm readiness.
